How to Nail Your First Consulting Project Kickoff

StrategyCase.com cover showing consultants beginning a project kickoff meeting in a modern conference room.

Last Updated on July 16, 2026

By Florian Smeritschnig, Former McKinsey Senior Consultant · Updated July 2026

Kicking off a consulting project well comes down to one thing: turning a fuzzy scope and a room of strangers into a team with a plan, in under two weeks. That is the whole job of a consulting project kickoff.

Your first project is where a lot of new consultants quietly panic. You have the offer, the badge, and a manager who expects you to add value by Friday, but nobody sat you down and explained how a project actually starts.

The first two weeks set your reputation on the team, and if you fumble them, you spend the rest of the engagement digging out. This is the playbook I wish someone had handed me. It comes from five years running engagements at McKinsey and is adapted from my book, Consulting Career Secrets.

Key Takeaways

  • A consulting project kickoff is the first one to two weeks of an engagement, not a single meeting. Treat it as a setup phase.
  • The best first-week signal you can send is a hypothesis-driven workplan plus one small, tangible deliverable by day 10, not a perfect analysis.
  • Do your homework before day one: read the proposal, research your own team, and map the client’s internal politics. Half the mistakes new consultants make are avoidable with 90 minutes of prep.
  • Get data requests out on day one. Access and data are the two things that stall projects, and both take longer than you think.
  • In 2026, on-site is no longer the default. Hybrid kickoffs need deliberate norms and shared tools, or the team never gels.

What Is a Consulting Project Kickoff?

A consulting project kickoff is the opening phase of an engagement, usually the first one to two weeks, when the team agrees on scope, roles, and governance, meets the client’s key sponsors, secures data access, and builds the workplan. It ends when the project runs on a predictable rhythm instead of ad-hoc scrambling.

Most new consultants hear “kickoff” and picture a single meeting with the client. That meeting matters, and I cover it below, but it is one item on a longer list. The real work of a kickoff is converting a signed proposal into a team that knows what it is doing every morning.

The first week or two of any project tends to feel messy. The team is still forming, logistics are half-sorted, the scope is fuzzier than the proposal made it look, and the client is still getting used to having you around. That is normal. Your goal is not to eliminate the mess. It is to move through it faster than the team next door.

This applies whether you are a fresh analyst on your first engagement, an experienced hire starting your first project at a new firm, or the associate who now has to staff and run the setup. It applies at McKinsey, BCG, and Bain, and at boutiques where the process is less formalized and you have to supply the structure yourself.

Before You Meet the Client: The First 48 Hours

The consultants who kick off well are the ones who did the boring prep before day one. The strongest new joiners diagnose the situation before they act, the discipline Michael Watkins describes in Harvard Business Review. You can do most of this prep in an afternoon, and it pays off for the entire engagement.

Read the project and its context

Start with the proposal or statement of work. Read it twice. The first read tells you what the client bought. The second read tells you what is vague, because the vague parts are where scope creep and awkward conversations live later.

Then build context around it:

  • Learn the client’s business. Skim the last two annual reports, recent earnings calls, and the investor deck. You want to walk in knowing how they make money and what is keeping the CEO up at night.
  • Learn the industry. Read a sector primer and the two or three biggest competitors’ latest moves. If you cannot explain the client’s competitive position in three sentences, keep reading.
  • Set up monitoring. Create a news alert for the client and its main competitors so you catch developments during the project. In 2026, I also feed a few earnings transcripts and press releases into an AI tool and ask for a one-page primer with sources, then verify the claims. It cuts hours off the first-day scramble.

Do due diligence on your own team

New consultants research the client and forget to research the people they will actually spend 60 hours a week with. That is backwards.

Find out who your manager and partner are, how they like to work, and what they are known for. Ask two or three colleagues who have worked with them: How do they give feedback? Do they want a heads-up before problems, or solutions on a plate? Are they early risers or late-nighters? If you can get a deck from a past engagement they led, read it.

You will learn their standards for what “good” looks like before you produce a single slide.

This is not politics. It is how you avoid spending week one guessing at expectations you could have simply asked about.

Read the client’s internal politics before you walk in

Every client organization has fault lines, and the org chart hides most of them. Knowing them early keeps you from stepping on a landmine in your first week.

Here is why this matters. On one of the most prominent clients I worked with, the division CEO who sponsored our project and the global CEO could not stand each other and refused to speak directly. Everything routed through intermediaries. A consultant who did not know that could easily have cc’d the wrong person on the wrong email and torched the sponsor’s trust in a single message.

We knew, so we managed the two channels carefully and kept our sponsor covered.

You will not get the full picture before day one. But ask your manager who the sponsor is, who the sponsor is threatened by, and who on the client side actually wants this project to succeed versus who sees it as a threat. Those three answers are worth more than any slide.

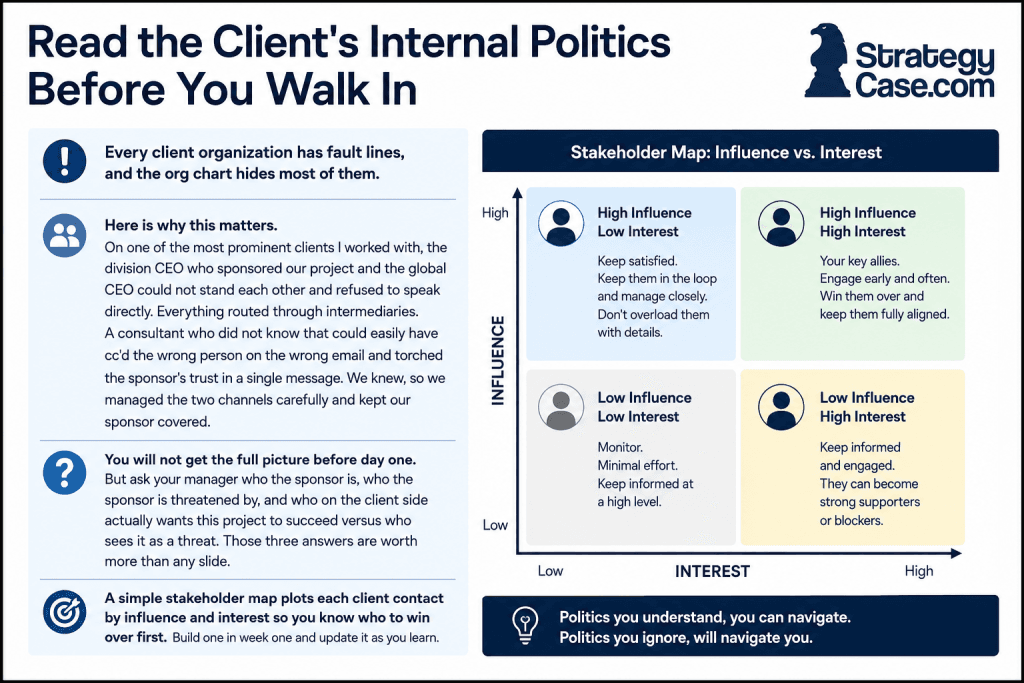

A simple stakeholder map plots each client contact by influence and interest so you know who to win over first. Build one in week one and update it as you learn. Useful for a consulting project kickoff

What Actually Happens in the Kickoff Meeting

The kickoff meeting is the client’s first real experience of how your team operates, so it sets the tone for everything after. Run it well and people relax. Run it badly and you spend weeks rebuilding confidence.

A strong kickoff agenda covers six things. The Project Management Institute’s guidance on kickoff workshops lands on a similar list, and it holds up across firms.

Agenda itemWhat to coverWhy it matters
ObjectivesThe single question the project must answerEveryone rows in one direction
ScopeWhat is in, and explicitly what is outPrevents scope creep and awkward “we thought that was included” talks
Roles and decision rightsWho owns what, and who signs offNo decision stalls waiting for an unnamed approver
Governance and cadenceSteering committee, weekly check-ins, status updatesThe client is never surprised, which builds trust
Data and accessWhat data exists, who provides it, by whenYou cannot analyze what you cannot get
First 3 to 5 tasksThe immediate next steps and their ownersTurns alignment into motion the same day

Two things new consultants get wrong here.

First, they spend the whole meeting on the end goal and skip the near term. Reserve real time for the first one to two weeks. Naming the first three to five tasks and their owners is what stops the project from drifting after everyone leaves the room.

Second, they over-share. In a kickoff, you are still learning who is in the room and what they are sensitive about. Be warm, be clear, and hold back opinions on findings you do not have yet. You can always say more next week. You cannot unsay a half-formed judgment in front of the client’s rivals.

Build the Workplan Around a Hypothesis, Not a Framework

This is the biggest gap between consultants who start strong and those who spin their wheels. Weak consultants open a blank page and try to analyze everything. Strong consultants start from an answer.

A hypothesis-driven workplan begins with your best current guess at the answer, then works backward to the few analyses that would prove or disprove it. You are not committing to being right. You are giving the team a spine so that every piece of work ladders up to the core question instead of piling up as interesting but useless analysis.

Sequence it with the 80/20 rule. Most of the insight on any project comes from a small slice of the possible work, so find that slice first. I wrote a full guide on applying the 80/20 principle in consulting, and it is the single habit that most separates fast junior consultants from slow ones.

Concretely, by the end of week one your workplan should show:

  1. The core question, stated as one sentence.
  2. Two or three hypotheses that would answer it.
  3. The specific analyses that test each hypothesis, with an owner and a rough due date.
  4. The data each analysis needs, cross-checked against your data requests.

Set Up the Team and the Team Room

A project is a small startup that has two weeks to become functional. Two things make it functional: clear norms and working logistics.

Agree on team norms early, especially for hybrid work

Sit down with the team in the first days and agree how you will work. Assessing working styles helps here. Plenty of teams use a lightweight personality read such as the Myers-Briggs indicator as a conversation starter, but you do not need a formal tool. A 20-minute “how do you each like to work” chat does most of the job.

Then agree the practical norms: core hours, when you are on-site versus remote, how you handle meals and check-ins and check-outs each day, and which tools you use for files, chat, and the workplan.

In 2017, this was easy because everyone sat in the same room. In 2026, many engagements are hybrid, and that changes the setup. If half the team is remote on any given day, you need shared tools and explicit norms, or the team never gels and information gets siloed. Decide on day two how a hybrid week actually runs. Do not let it happen by accident.

Handle the logistics that quietly derail week one

The unglamorous stuff sinks more first weeks than bad analysis does. Get ahead of it.

  • Access. Sort building badges and Wi-Fi credentials before day one if you can. A consultant locked out of the building or the network is billing the client to stand in a lobby.
  • A team room. Secure a decent room to work from on-site. Push for a real one. I once spent an engagement working out of a storage shed just outside the client’s headquarters because nobody arranged space in advance. Do not be that team.
  • Equip it. Basics still matter: a screen or two, a conference line, a printer if the client still uses one, chargers, and flipcharts or a whiteboard. Some firms keep a “team room in a box” you can request. If yours does, use it.
  • Your own gear. A few reliable items make the road tolerable. I put the ones worth buying in this guide to must-have items for new consultants.
  • A client-ready slide template. Set up a deck template that matches the client’s colors, fonts, and formatting early. It signals care and saves the team from reformatting under deadline.
  • Support capacity. If your firm offers slide designers, data analysts, or research desks, book their time early. The good ones are staffed weeks out.

Get these right and week one feels controlled. Ignore them and you lose two days to problems you could have solved with a few emails.

Score an Early Win by Day 10

Trust on a new project is built with a small, visible result long before the final answer exists. Aim to put one tangible thing in the client’s hands by around day 10: a clean data cut, a crisp problem statement everyone agrees on, a quick benchmark, or a resolved question that was nagging them. It does not have to be the answer. It has to be real and useful.

None of that happens without data, which is why you start collecting it on day one, not week two. Send your data requests within the first three days. Data access is the single most common thing that stalls a project, and it almost always takes longer than the client promises. Keep a simple tracker of what you asked for, from whom, and when it is due, and chase politely but relentlessly.

Here is how the first two weeks tend to look when a kickoff goes well.

WhenFocusWhat “done” looks like
Before day 1PrepYou have read the proposal, researched your team, and mapped the client’s politics
Days 1 to 2KickoffScope, roles, governance, and the first 3 to 5 tasks are agreed and written down
Days 1 to 3DataRequests are out; you are not waiting until week 2 to ask
Days 3 to 7WorkplanA hypothesis-driven workplan with owners and a first-cut answer exists
Days 7 to 10Early winOne tangible deliverable is in the client’s hands
Days 10 to 14RhythmWeekly cadence is set, and the project feels predictable rather than reactive

Use AI to Accelerate Your Kickoff in 2026

The setup work above used to eat your first two days. A lot of it now takes an hour if you use AI well, and knowing how is quickly becoming part of the junior consultant’s job. I dug into this shift in a separate piece on how AI is changing the junior consultant role.

Where it helps most during a kickoff:

  • Context primers. Feed in annual reports and transcripts and ask for a sourced one-pager on the client and its competitors. Then verify every claim before you repeat it.
  • First-cut structure. Use it to pressure-test your issue tree or hypotheses, not to write them for you. The thinking has to be yours.
  • Synthesis. Turn messy interview notes into a clean summary you then edit.

One rule: AI accelerates the prep, it does not replace the judgment. Every number and claim you put in front of a client has to be one you have checked yourself. That standard is exactly what keeps your work trustworthy, and it is the same standard the firms hold you to.

Common First-Two-Weeks Mistakes to Avoid

Most kickoff failures are a handful of avoidable errors. Watch for these:

  • Analyzing before you have a hypothesis. You end up with a pile of charts and no story.
  • Waiting on data. Every day you delay a data request is a day added to the back end of the project.
  • Over-promising in the kickoff. Confident claims about findings you do not have age badly.
  • Ignoring the client’s politics. One misrouted email to the wrong person can undo weeks of trust.
  • Letting logistics slide. No room, no access, no template. Small problems that compound fast.
  • Going quiet when confused. Ask early. Silence in week one reads as “lost,” not “independent.”

For the wider set of traps that catch people early in the job, I keep a running list of the top mistakes to avoid as a junior consultant. And because these first weeks are intense, protect your energy from day one. The good habits you build now cost far less than the burnout you would otherwise have to repair later.

Make Your First Project a Launchpad

Your first consulting project kickoff is a compressed version of the whole job: align a team, read a client, structure a problem, and deliver something useful under pressure. Get the first two weeks right and you earn the reputation that gets you staffed on better work next time.

To recap the playbook:

  • Do the prep before day one: proposal, team, and client politics.
  • Run a kickoff that names scope, roles, governance, and the first few tasks.
  • Build a hypothesis-driven workplan and get data requests out immediately.
  • Set up the team, the room, and hybrid norms so logistics never slow you down.
  • Land one real deliverable by day 10, then settle into a weekly rhythm.

At StrategyCase, most people find us for interview help, but the ones who reach back out months later are usually asking exactly this: how do I not look lost on my first project? This is the answer.

the image is an introduction of the book consulting career secrets by dr florian smeritschnig

If you want the full version, with the templates, checklists, and war stories behind each step, it is all in my book, Consulting Career Secrets, part of the StrategyCase library. Grab it before your start date, read it once on the plane, and walk into your kickoff as the consultant who clearly already knows how this goes.

Frequently Asked Questions

What should I do in the first week of a consulting project?

Read the proposal and client context, do the kickoff meeting to lock scope and roles, send your data requests, and start a hypothesis-driven workplan. By the end of week one, the team should know the core question, the first few tasks, and who owns them. Aim to have one small deliverable ready by around day 10.

What happens in a consulting project kickoff meeting?

The team and client align on objectives, scope, roles and decision rights, governance and meeting cadence, data and access, and the first three to five tasks. The most useful kickoffs spend real time on the near term, not just the end goal, so work starts immediately instead of drifting.

How long does a consulting project kickoff take?

The kickoff meeting itself usually runs one to four hours. The full kickoff phase, meaning the setup that makes the team functional, takes about one to two weeks. You know it is done when the project runs on a predictable weekly rhythm instead of daily scrambling.

How do I prepare for my first consulting project if I have no experience?

Prepare before day one. Read the statement of work twice, skim the client’s annual report and main competitors, and ask two colleagues how your manager likes to work. Then focus week one on structure and data. Nobody expects perfect answers in week one, however preliminary answers are common. They expect you to be organized and to ask good questions.

What is a hypothesis-driven workplan?

It is a plan that starts from your best guess at the answer and works backward to the few analyses that would prove or disprove it. Instead of analyzing everything, you test a small set of hypotheses. It keeps the team focused and is how top firms avoid drowning in analysis that does not lead anywhere.

How do consulting kickoffs work when the project is remote or hybrid?

The same phases apply, but you have to be deliberate about norms and tools since the team is not sitting together. Agree in the first days how a hybrid week runs, which tools hold the files, chat, and workplan, and how you keep remote members in the loop. Left to chance, hybrid teams silo information and lose the informal learning that makes junior consultants better.
